NEM Agreement Application/Interconnection Application:
The doc you upload to the portal needs to be the same completed doc you send to the utility. It doesn’t need to be countersigned by the utility or accepted yet.

These are the CAD drawings or engineering plans for the system that you are using for your permit application. Send the complete plans not just the first page. These plans must be in PDF form.
To Cover FEOC/DC Requirements:

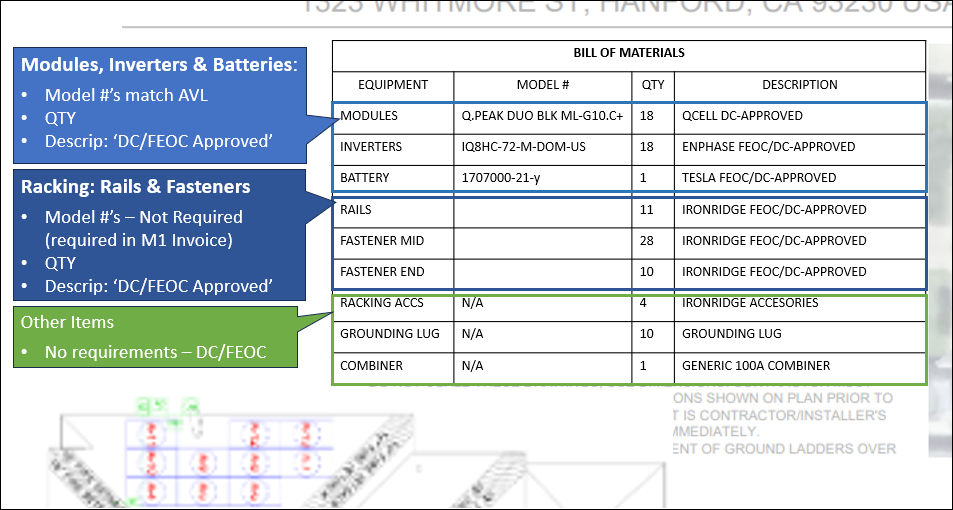

BOM must list the following information for equipment.
Modules: SKU, QTY, Manufacturer, FEOC-Approved in description
Inverters: SKU, QTY, Manufacturer, FEOC-Approved in description
Battery: SKU, QTY, Manufacturer, FEOC-Approved in description
Racking: QTY, Manufacturer, FEOC-Approved in description (racking SKU's not needed until M1)
The Model #’s/SKUs must appear on HDM’s AVL as FEOC/DC Eligible
----------------------------------------
Confirmation Call
Upload a doc to tell us the call has been completed and we'll look it up in the call database to verify it.
Upload one of these:

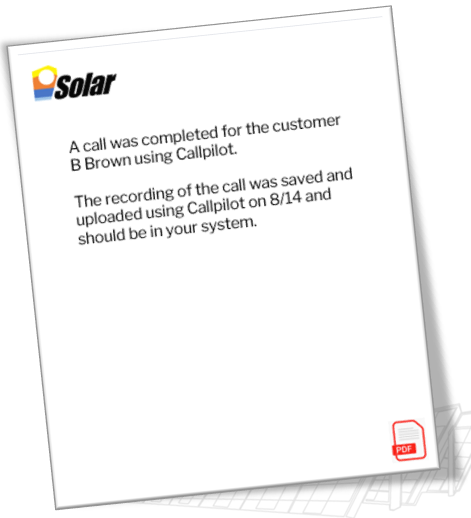

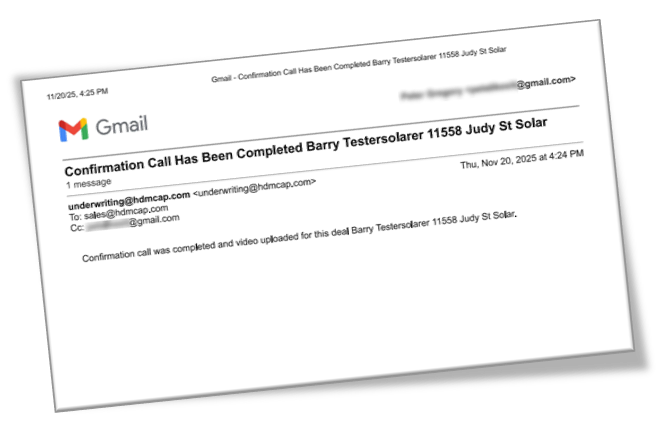

Upload the email that Callpilot sends
the sales rep after the call. This tells HDM to find the recording on the
Callpilot server.
or
Upload manual recording if the call was done not using Callpilot.

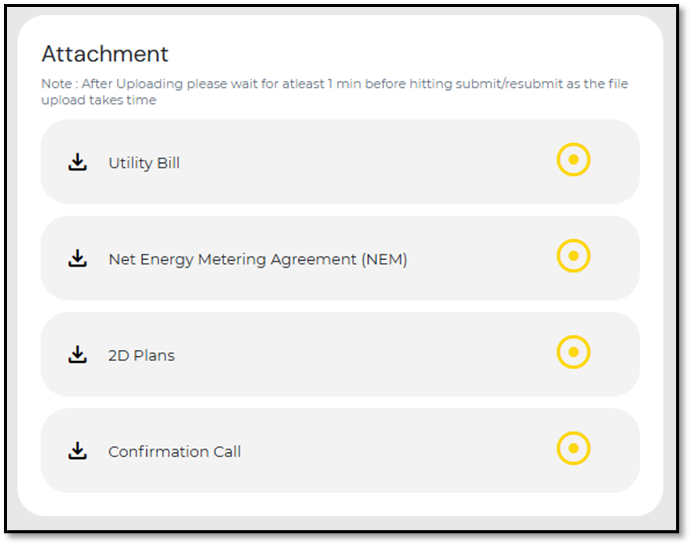

In the Portal

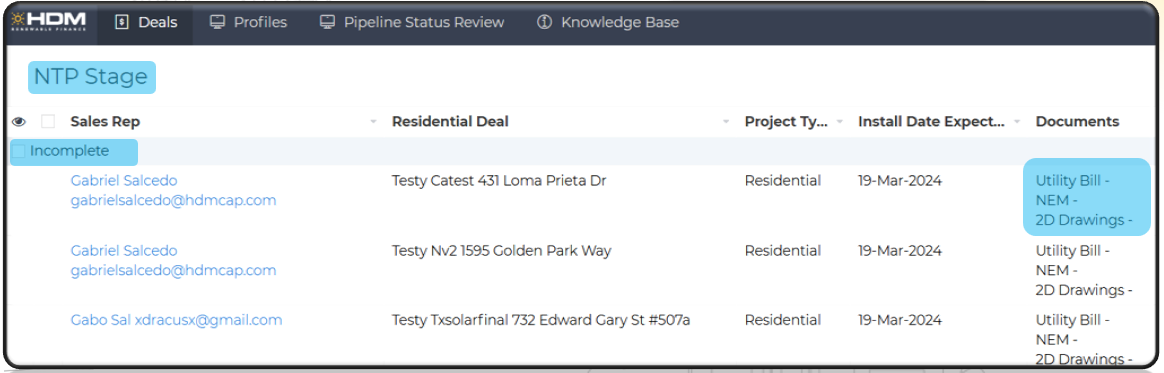

Your newly signed customers will be listed in the portal under the ‘NTP Stage’.
What you need to do:
Click into a customer record by tapping the document column.
You'll land in the NTP page for that customer

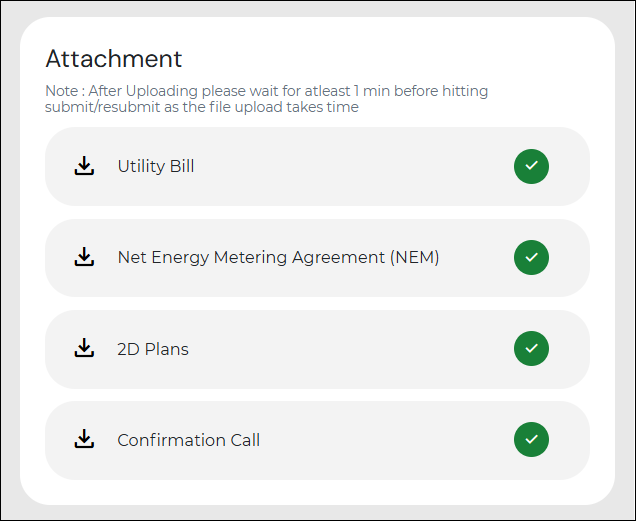

Click Upload in the Attachments section
Upload the required docs

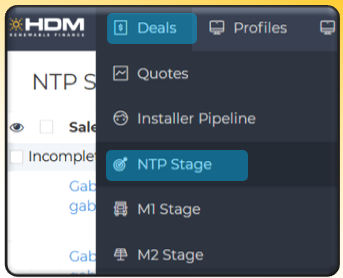

Find Your Projects
Your recently signed customers will be listed under the NTP Stage on the portal
Equipment used in your system must be listed on the AVL.
In all cases: the inverters, batteries and racking used require matching model#'s on the AVL.
In most cases: modules require matching model#'s on the AVL too.

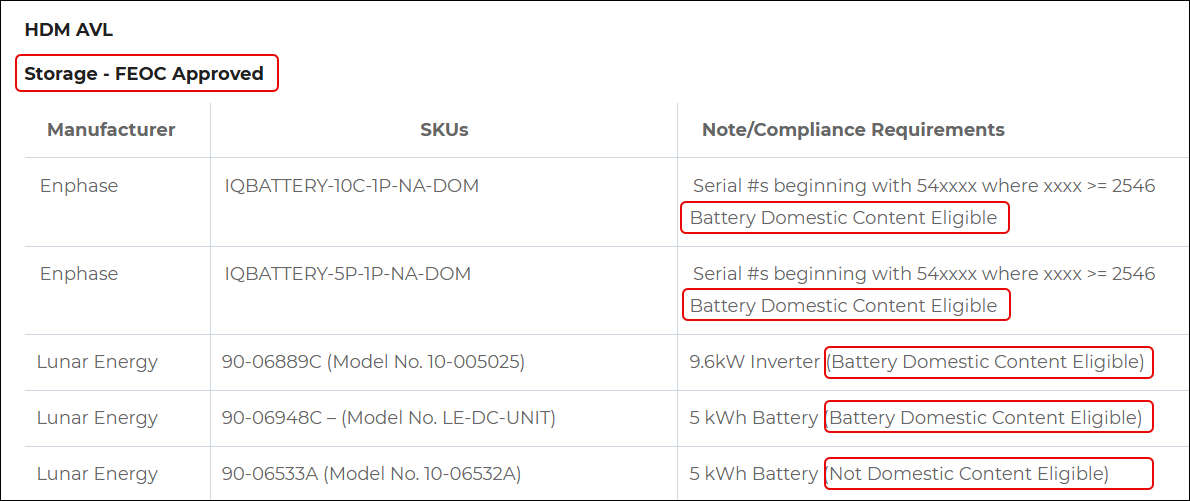

The HDM AVL covers FEOC and Domestic Content requirements on a single page.
Each section: Lists if contents are FEOC approved
Individual items: List of DC approved (in right-hand column)
A note About Enphase:
For Enphase batteries to be FEOC approved, they must display a serial number with the following characteristics.
The lasr number ser must begin with '54'. The next two digis must be equal to or greater than 25 (for 2025). The next two digits must be 46 or higher (46th week of the year).
Use this guide to clarify the AVL's FEOC and DC guidlines:
HDM - Portal for Underwriting Process View this video or read the article below: Portal Access As a member of the project management team with an official HDM partner you should have access to the portal. If you don’t yet have a login, request one ...
HDM - NTP Rejections and Questions View this video or read the article below: Common Rejections Title Rejection A few common reasons for title rejections: Title database doesn't list a new title: In this case, title-confirming docs like a deed may be ...
HDM Operations Overview View this video or read the lesson below: What HDM Offers HDM offers a Prepaid PPA. These are the results of the agreement: Before HDM will fund their portion, the project must go through the underwriting process described ...
Puerto Rico Underwriting Overview Underwriting Milestones: NTP (Notice to Proceed) You'll upload the following docs to the portal. In this milestone HDM will be checking to see if everything described in the NTP docs matches what is described in the ...
HDM Underwriting - FAQ and Exceptions View the video or read the article below: Topics Covered: When no Building Permit is Required No PTO Required Add-On/Expansion New Construction Large Storage Off-Grid Guidelines AHJ Says: No Building Permit ...
