Title database doesn't list a new title: In this case, title-confirming docs like a deed may be requested
Signer not listed on title: In this case a spuse who is listed on the title should sign the agreement instead.
Address Doesn't Match Title
The Quoter tool has an address verification feature but it is still possible the wrong address can be selected or entered, or there is a typo in the address.
Revising a PPA address is done with a change order.
Confirmation Call Incomplete or Missing
It's possible that a confirmation call occured, but was not completed or it containied errors.
Calls may be rejected if a name doesn't fit a face. For example: male/femail face mismatch.
Calls attempeted on re-used email links are also marked for rejection. Each customer has a unique call link that must be used.
In most cases a new call must be completed. This can be done using the original call link for that customer.
Incorrect System Size
If there was a change in the size between the signing and NTP submission date...
The PPA needs to be revised to match the planned installation an be re-signed.
This is done with a change order.

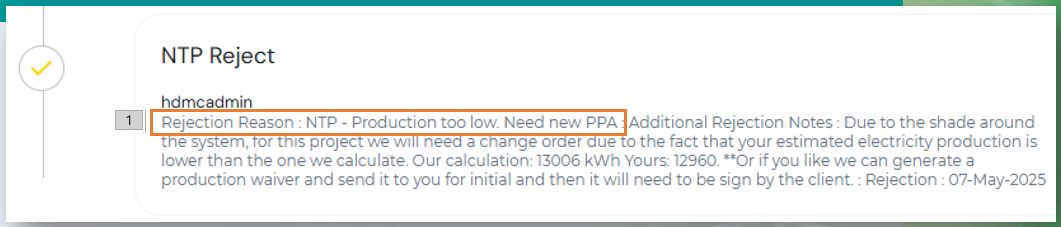

Production Out of Range Rejection
A production rejection happens when...
- The Year-1 production estimate on the PPA...
Is higher than...
- The Year-1 estimate run by HDM during NTP review.
The PPA will need to be revised witha year-1 production estimate that is equal to or lower than HDM's.
This si doen with a change order.
Utility bill or NEM Rejections
A rejected Utility Bill may be:
More than a year old
Not legible
Missing infor: Nmame, Address, Utility
A rejected NEM Application may be:
Listing a different system sie than the agreement
Missing pages
AVL, 2D Plans, BOM Rejections

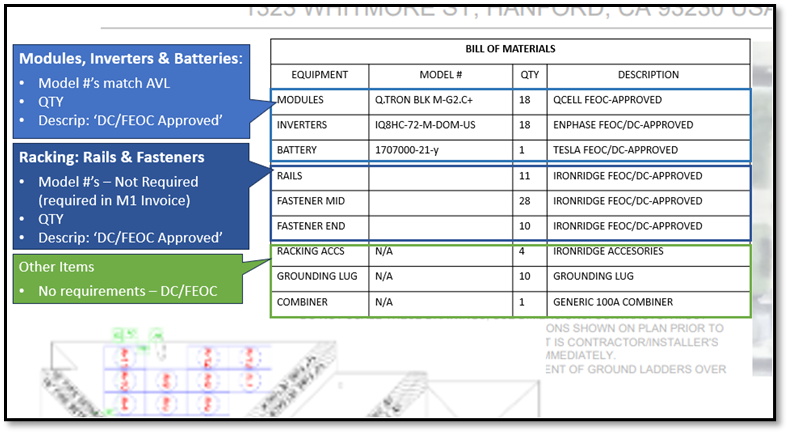

Rejected 2D Drawings may be missing a BOM listing the following:
Modules: SKU, QTY, Manufacturer, FEOC-Approved in description
Inverters: SKU, QTY, Manufacturer, FEOC-Approved in description
Batteries: SKU, QTY, Manufacturer, FEOC-Approved in description
Racking: QTY, Manufacturer, FEOC-Approved in description (racking SKUs not needed until M1)

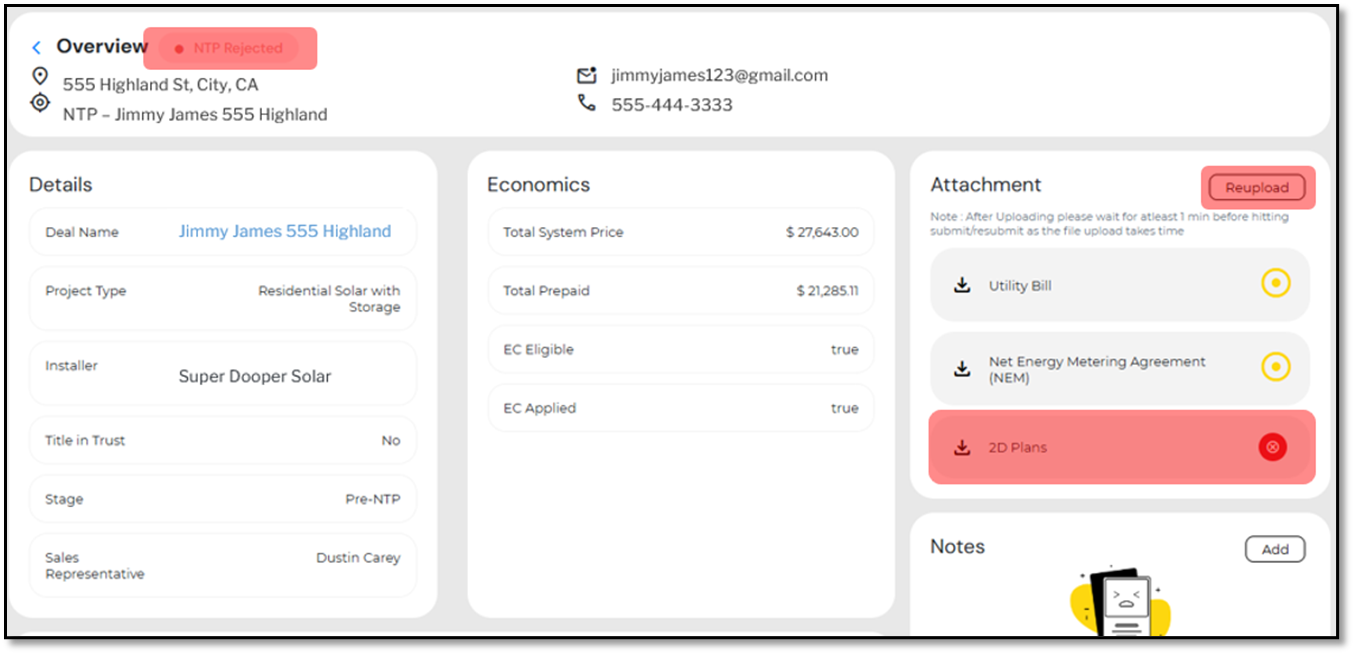

This will produce a list of your rejected projects.
Tap into a project.
The NTP page should show the project as Rejected.
In the attachment section the unacceptable files should be labeled with a red circle.
Tap Reupload to load the correct document.
The Timeline for Rejection and Resubmission lower on the page should list rejection details.
When a rejection Requires a Resign
Certain rejections require
re-signing a new PPA (Change Order).
If the signed PPA doesn’t match the
planned system described in the NTP docs, a new PPA must be signed that does
match.
The following changes require a re-sign/change order:
Change to Customer Name
Change to Site Address
Change to the Turn-Key Amount
Change to the System Size (SOlar or Storage)
Change ei Year=1 Production Estimate
The Change Order / Re-Sign Process
The HDM Underwriting team will
inform you of the rejection and the need for a Change Order which will create a new agreement
and delete the old project.
When a rejection requires a re-sign, a change order must be used. This closes the old job and creates a new project in the portal and new documents for signing.
Simply creating an additional quote is no longer an option. Only one quote is allowed per customer and the change order process takes care of that requirement.
When a change order is needed, it will require some coordination between Sales and Project Management because this takes place on the project detail page
Change Order Process
Click Change Order from the Project Detail page
Select a Change Order Criteria from the drop down and Submit
You land in the quoter tool for the new quote
Complete the missing fields.
Submit the change order. This will close the old job and create the new one
Send your new docs
After signing, underwriting starts on a new project/NTP page
The FAQ and Exceptions Lesson
The FAQ and Exceptions lesson describes the guidelines around exceptional projects.
HDM NTP Basics View this video or read the article below: ALL JOBS FOLLW THE SAME NTP DOC REQUIRMENTS Four required docs to submit at NTP: Utility bill 2D Plans NEM application Conformation call email Notice to Proceed Purpose of step: Clearly ...
Puerto Rico Underwriting Overview Underwriting Milestones: NTP (Notice to Proceed) You'll upload the following docs to the portal. In this milestone HDM will be checking to see if everything described in the NTP docs matches what is described in the ...
HDM M1 – Substantial Completion View the video or read the article below: In the M1 stage, the installer shows substantial completion of the solar project. ALL JOBS FOLLOW THE SAME M1 DOCUMENT REQUIREMENTS Required Docs The following docs need to be ...
HDM Operations Overview View this video or read the lesson below: What HDM Offers HDM offers a Prepaid PPA. These are the results of the agreement: Before HDM will fund their portion, the project must go through the underwriting process described ...
HDM Underwriting - FAQ and Exceptions View the video or read the article below: Topics Covered: When no Building Permit is Required No PTO Required Add-On/Expansion New Construction Large Storage Off-Grid Guidelines AHJ Says: No Building Permit ...
