Underwriting 5 - M1 (Milestone 1)

Underwriting 5 - M1 (Milestone 1)

HDM M1 – Substantial Completion

View the video or read the article below:

In the M1 stage, the installer shows substantial completion of the solar project.
ALL JOBS FOLLOW THE SAME M1 DOCUMENT REQUIREMENTS

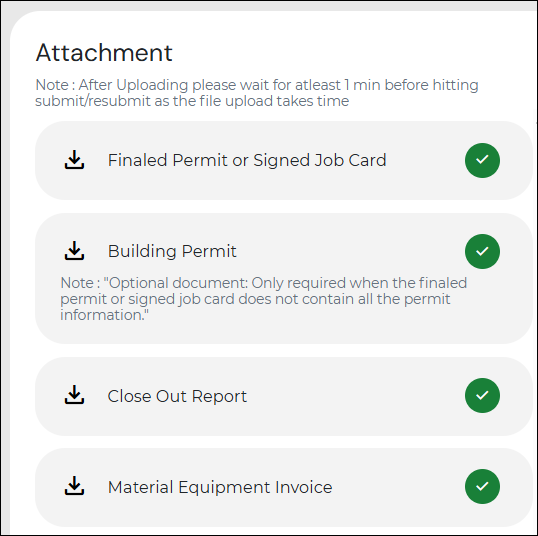

Required Docs

The following docs need to be uploaded to the HDM Underwriting Portal for all jobs
  1. COR: Close-Out Report (installation pictures)
  2. Signed Job Card (or finaled permit)
    1. Full Building Permit - Only required when the finaled permit or signed job card does not contain all of the permit details.
  3. Materials Invoice: Listing Model #'s/SKUs

---------------------------------------

Finaled Permit + COR + Material Invoice

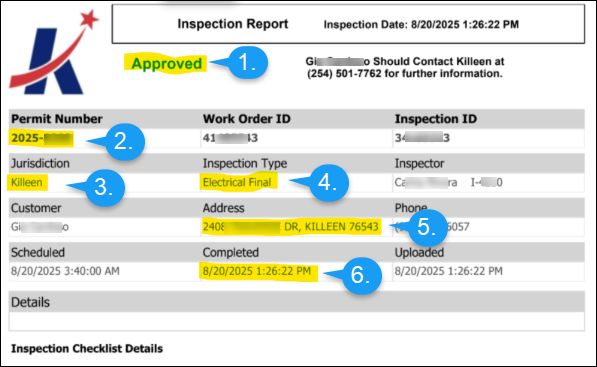

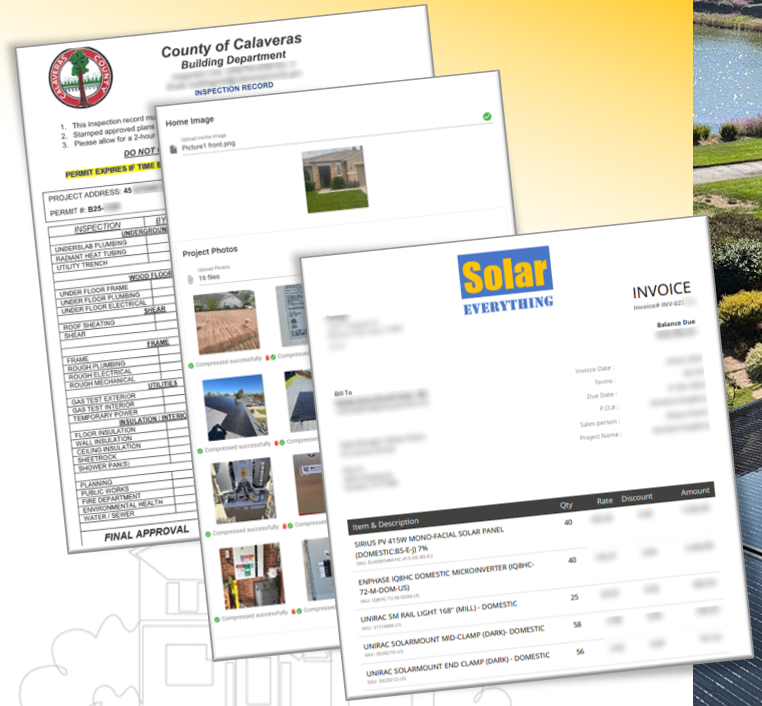

  1. Finaled Permit - What you receive after the inspection. Make sure it is finalizing the solar or battery installation.
  2. COR - Installation Photos. Use the COR generator built into the M1 page.
  3. Material Invoice - Show the model #'s of the equipment you purchased for the project.

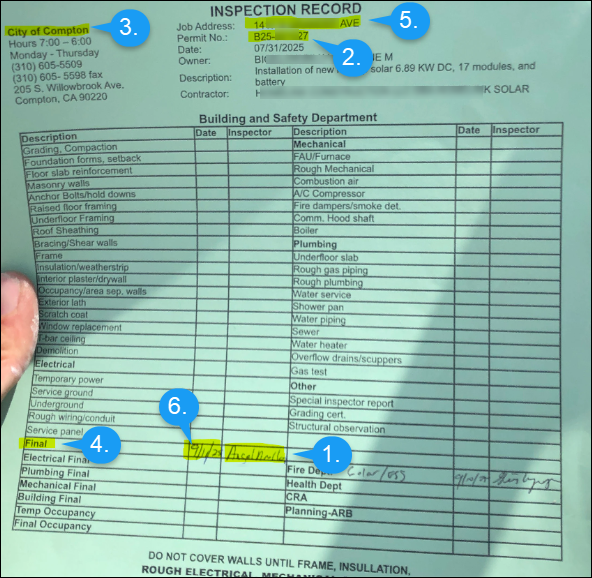

Finaled Permit Requirements

The finaled permit or signed job-card must include ALL of the following:
  1. Approved/Signature
  2. Permit #
  3. City/Jurisdiction Name
  4. Type: Final Solar, Final Electrical, Final Building
  5. Site Address
  6. Date of Inspection
If the final is missing any of these details, HDM will ask for the full issued permit to be submitted also.

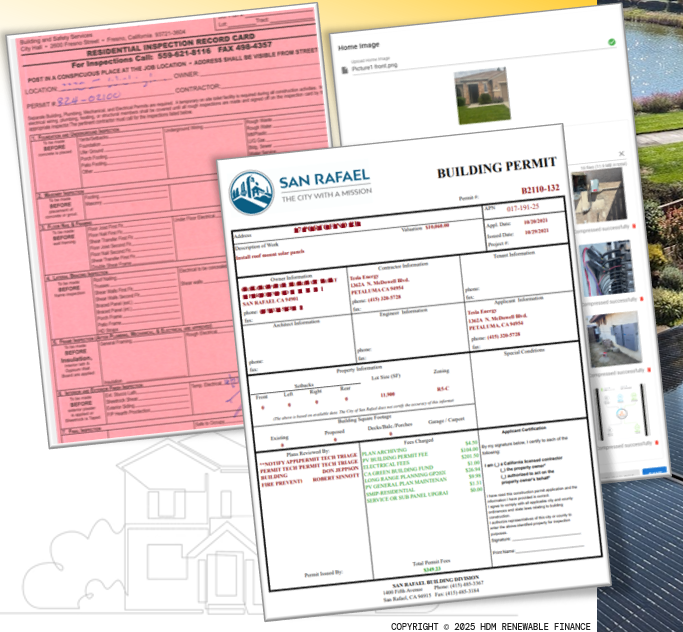

Examples of Acceptable Finaled Permits

What if No Permit Was Needed?

Please see the FAQ and Affidavit lesson

Produce a Closeout Report (COR)

Use the COR generator tool on the M1 page to create and load the Close Out Report.
  1. In the Attachment section hit the Upload COR button

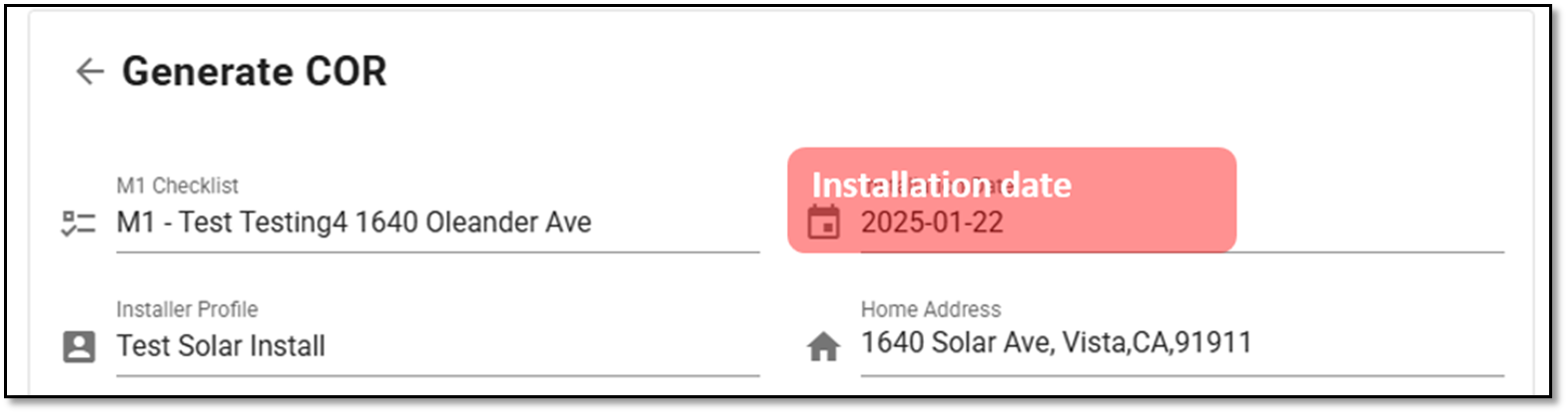

  2. Enter the Installation Completed Date
  3. Load all required photos
  4. Hit Save > Submit

-----------------------------

Close-Out Report Photo Requirements

The following photos need to be included in the COR

Solar COR Photos:
  1. Front of Home – showing address

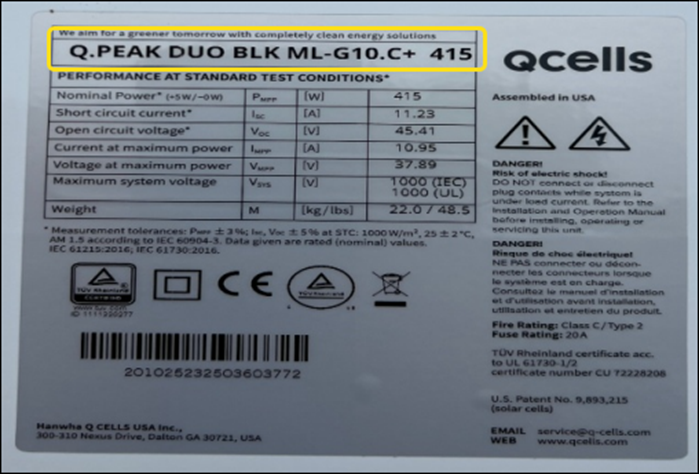

  2. Microinverter/Optimizer (face) – name plate
  3. Microinverter/Optimizer (edge) - serial#/model#
  4. Solar Module (placard) - serial#/model#
  5. Central Inverter (placard) – serial#/model#

  6. Installed Modules – ALL arrays

  7. Envoy/Gateway (for Micros) – serial# + model#
  8. Layout Mapping Sheet – Showing ALL Serials
  1. Roof – Prior to installation (optional)
  2. Point of Interconnection (optional)

-------------------

Storage COR Photos:
  1. Front of Home Showing Address

  2. Battery (main label) - serial#/model #
  3. Gateway/Transfer Switch – serial#/model #
  4. Wide Shot – all ESS equipment installed
  5. Screenshot of ESS Software – phone app
  1. Installed CT’s – closeup (optional)
  2. Battery Mounting plate – installed (optional)
  3. Installed Protections – curbs & bollards (optional)
  4. Electrical Panels – covers on w/labels (optional)
  5. Electric Panels – covers off w/wiring (optional)

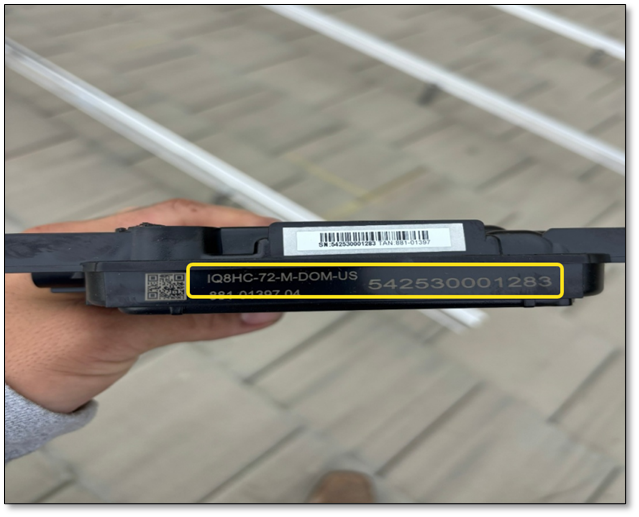

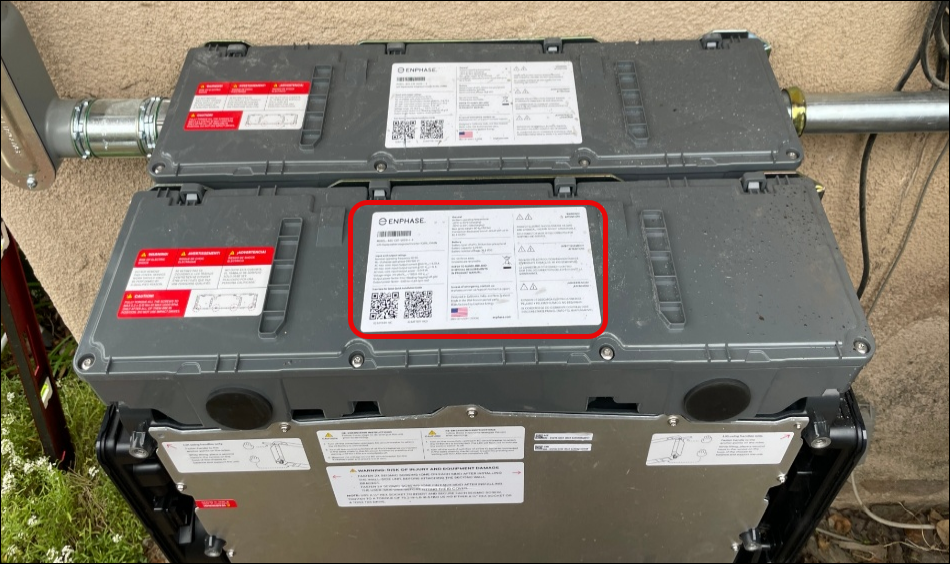

Enphase label

Enphase Serial and Requirements

COR Photos Note

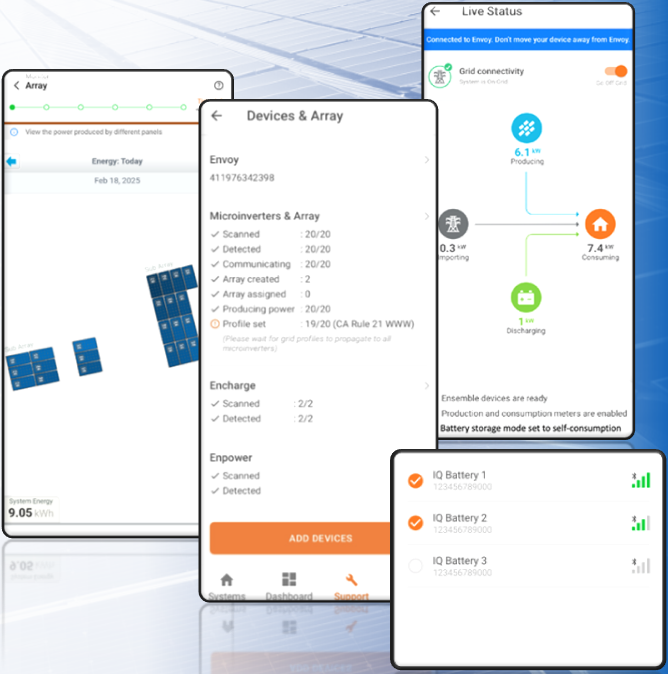

A screenshot of the monitoring site showing modules, envoy serial number and battery can be used in place of a missing mandatory picture.

If you’re missing photos the folowing: Screenshots from the monitoring can be substituted.
  1. Sub-arrays
  2. Layout mapping
  3. Gateway transfer switch serial
  4. Battery serials and model numbers

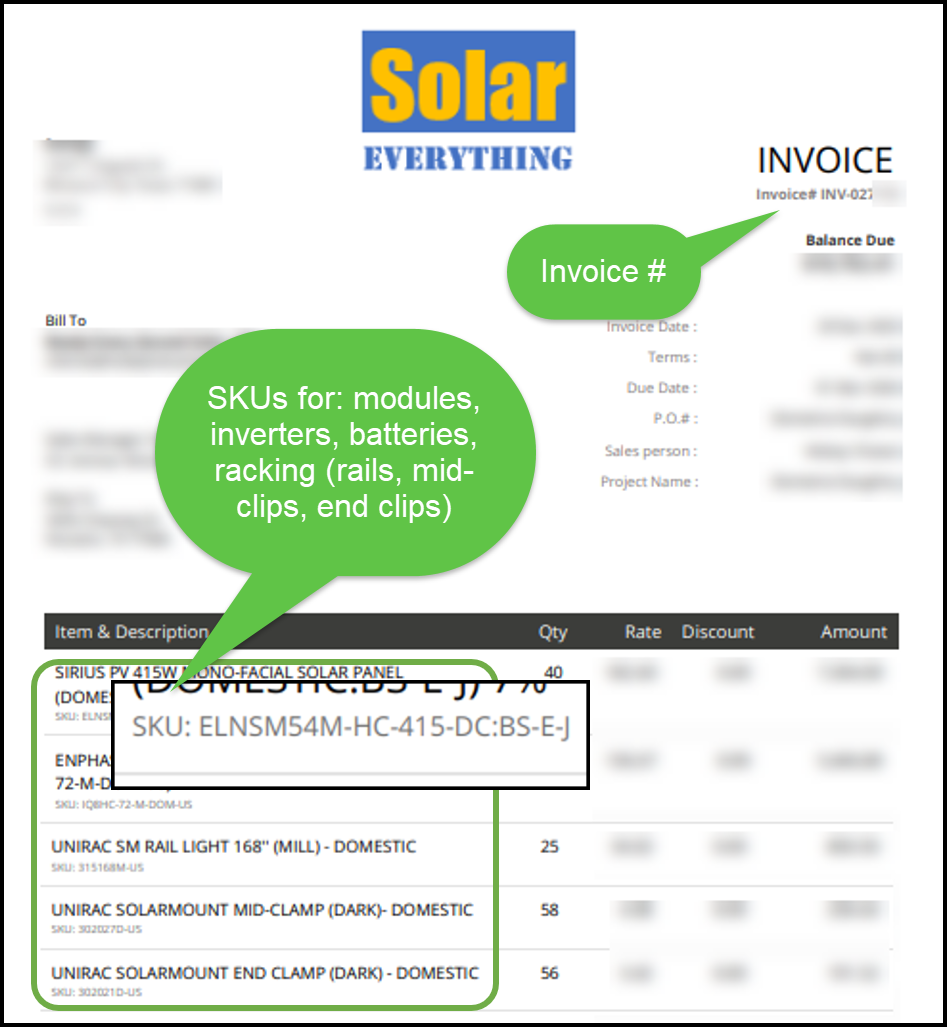

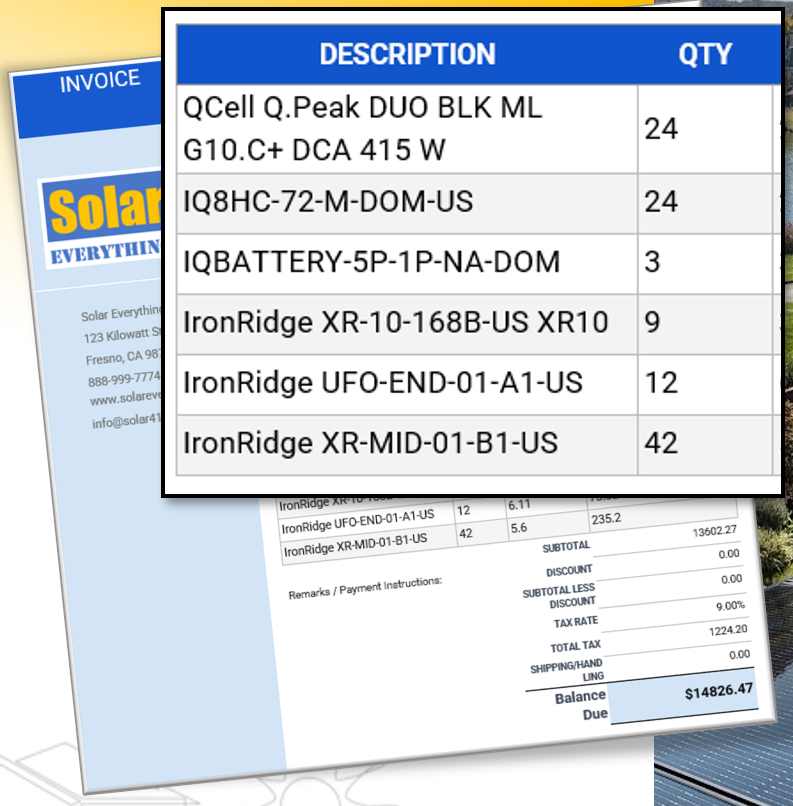

Material Invoice

A Material Invoice must be uploaded to M1 for all jobs.

Invoice must include:
  1. Invoice #
  2. Modules: SKU + QTY
  3. Inverter: SKU + QTY
  4. Battery: SKU + QTY
  5. Racking
    1. Rails: SKU's + QTY
    2. Mid-Clips: SKU's + QTY
    3. End-Clips: SKU's + QTY

No Packing Slip is Required
This requirement has been dropped for all jobs

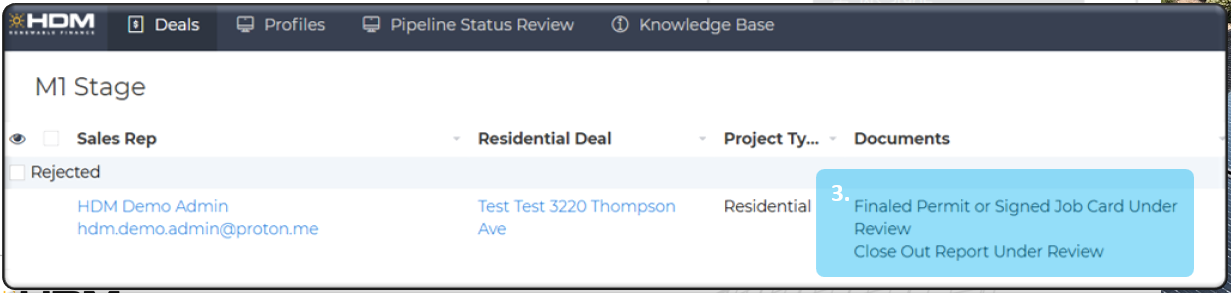

Find Your Project

In the portal:

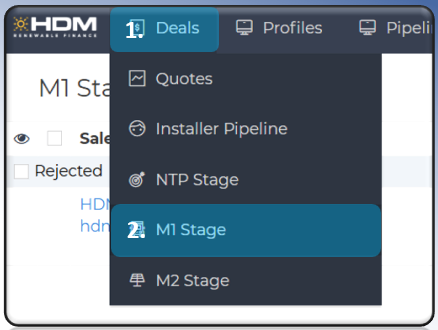

1.Tap the Deals tab
2.Tap M1 Stage
3.Tap the docs for your project

----------------------------------

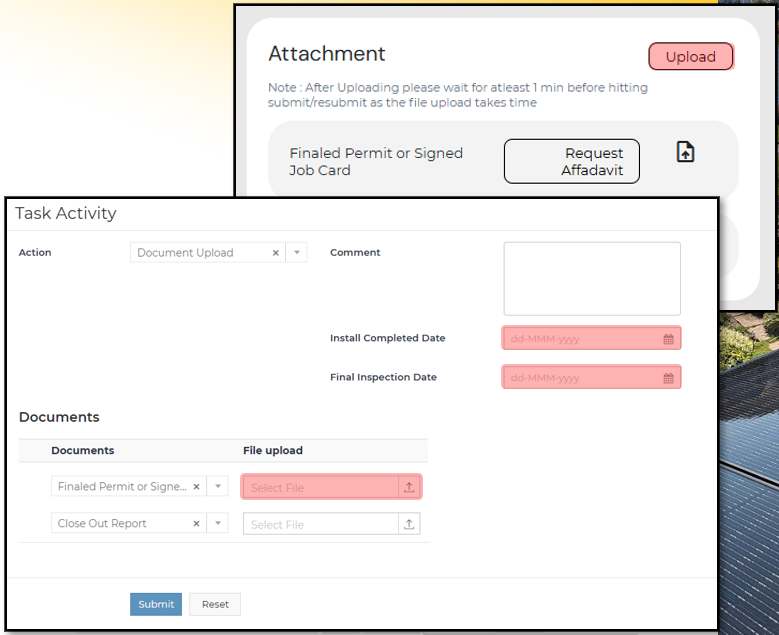

Upload the M1 Docs

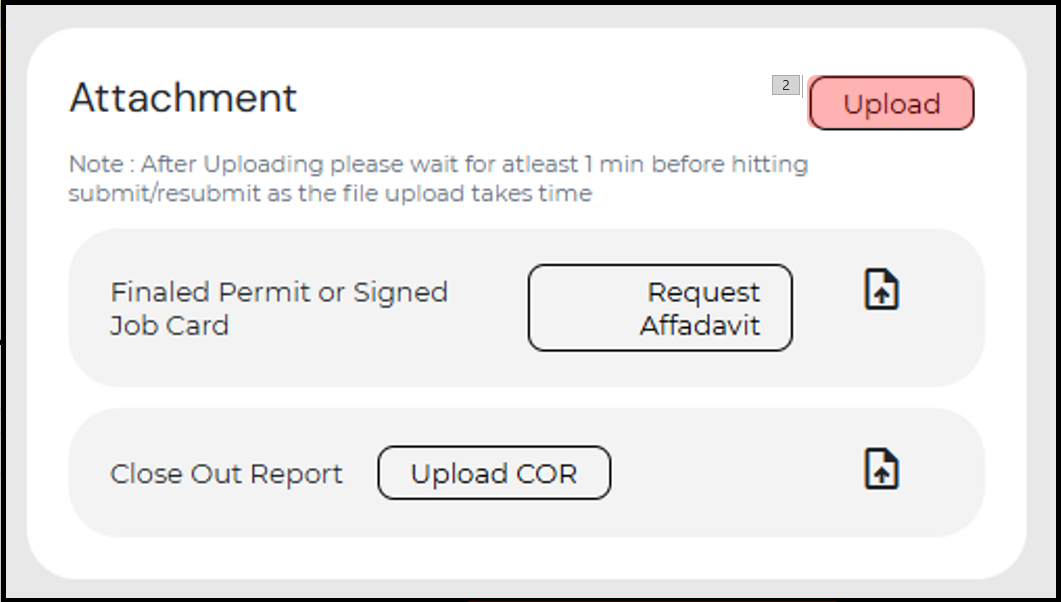

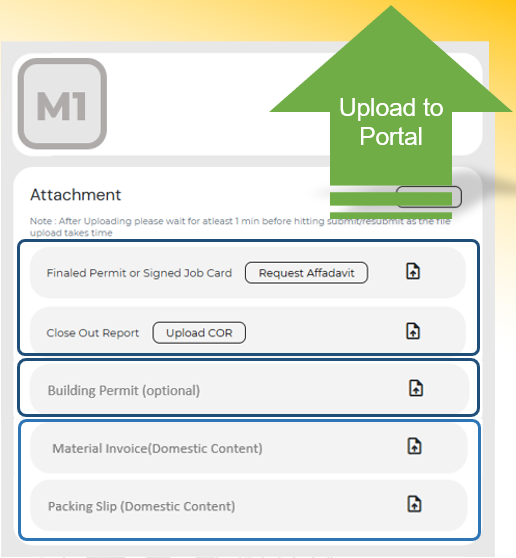

M1 Attachment section
  1. Hit Upload
  2. Enter Install Completed Date
  3. Enter Inspection Date
  4. Load the M1 docs

PPA Signed Before Inspection

If you’re working towards M1 and don’t have your final PPA signed at this point, this is the last chance to get one signed.

If you had to re-sign because of a rejection…

to be eligible for funding, you must have your final PPA agreement signed before the building inspection.

Don’t submit for M1 unless you have NTP approved with a final PPA that matches the info in  the NTP docs

M1 Approval

Once the M1 docs have been approved, HDM will email the installer the invoice.

This document (sent for e-signature) lists:

  • The 77% (or 80%) amount is to be paid by the customer.

  • The 23% (or 20%) amount is to be paid by HDM.

Must be signed by the installer and returned to HDM

Once the job has been M1 approved:

M1 Verification Statement #1 is sent to the installer:
  • Lists the requirements for M1 that have been met

  • Must be signed by installer to continue

M1 Rejections

M1 Rejections are very common.

Photo Rejections

Installers need to be reminded that not all photos can be taken at the end of the installation.

Signed Job Card or Finaled Permit
This needs to be the doc the building department issues to give final sign-off for the solar or battery system.
Make sure this doc isn't final-ing some other part of a construction project.

The 3 most commonly missing photos:
  1. Front of home showing address
  2. Photos showing ALL arrays & modules (load multiple photos)
  3. Roof before installation

    • Related Articles

    • Underwriting 7 - M2 (Milestone 2)

      HDM - M2 (Milestone 2) View the video or read the article below M2 is HDM’s pre-performance review. M2 Steps and Requirements What Happens During M2? HDM fleet team: Reviews existing production data on the monitoring platform Extrapolates future ...
    • Underwriting 1 - Overview

      HDM Operations Overview View this video or read the lesson below: What HDM Offers HDM offers a Prepaid PPA. These are the results of the agreement: Before HDM will fund their portion, the project must go through the underwriting process described ...
    • Underwriting 1 - Puerto Rico Overview

      Puerto Rico Underwriting Overview Underwriting Milestones: NTP (Notice to Proceed) You'll upload the following docs to the portal. In this milestone HDM will be checking to see if everything described in the NTP docs matches what is described in the ...
    • Underwriting 2 - HDM Portal Basics

      HDM - Portal for Underwriting Process View this video or read the article below: Portal Access As a member of the project management team with an official HDM partner you should have access to the portal. If you don’t yet have a login, request one ...
    • Sales Process 4 - Underwriting Overview for Sales

      HDM Sales 4 - Underwriting Overview View the video or read the article below Beyond Signing What happens on an HDM job after a customer is signed? These are the steps from signing through the end of the HDM underwriting process Signing After signing ...
